Blog Post 05.26.26
Alert
Alert
08.18.26
What Happened
On August 3, 2026, Governor Greg Abbott directed the Public Utility Commission of Texas (PUCT) and the Electric Reliability Council of Texas (ERCOT) to conduct a comprehensive verification and audit of data center projects advancing through ERCOT’s interconnection process before additional projects are approved to move forward. The directive states that projects failing to comply with applicable PUCT, ERCOT and state-law requirements must be denied connection to the Texas power grid.
The directive was issued amid extraordinary queue pressure. The Governor’s letter cites approximately 474 GW of pending requests to connect to the ERCOT grid, more than five times Texas’s record peak demand, with approximately 90 percent of new power requests attributed to data centers.
The directive requires project-level information on public financial assistance, self-supplied or grid-supplied power, projected annual and peak electricity use, planned water consumption and cooling technology, community impact mitigation, and ownership and controlling interests.
ERCOT and PUCT Response
ERCOT responded immediately. In an August 3 Market Notice, ERCOT stated that it would not issue the planned August 7 Batch Zero classification notices and would seek a PUCT good-cause exception related to Batch Zero timelines and processes.
ERCOT filed good-cause requests on August 10 seeking relief from deadlines, including the classification deadline, treatment of certain projects in Quarterly Stability Assessments and timing for dynamic-data deficiency notices. PUCT discussed the implementation effort at its August 14 open meeting. PUCT is expected to take action on ERCOT’s pending requests at the August 20 open meeting.
The review mandated by Gov. Abbott appears to have two principal workstreams: a Batch Zero eligibility verification for large loads generally at or above 75 MW, and a community-impact information collection process for unenergized computational loads generally at or above 25 MW. Projects at or above 75 MW that are computational loads may be subject to both workstreams.

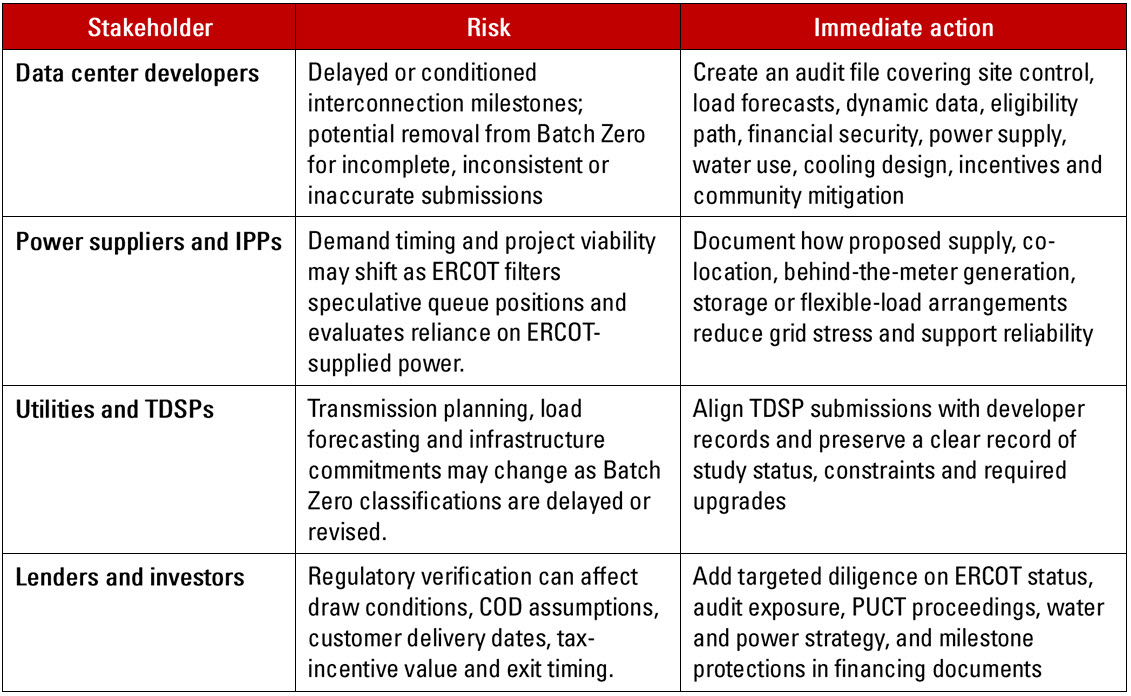

Key Risks by Stakeholder Group

Contracting and Diligence Implications
Salient Points
Pillsbury Perspective
Texas remains attractive for data center and power infrastructure investment, but the policy signal is clear: Projects seeking access to ERCOT grid capacity must be able to prove readiness, pay their own way, protect local resources and support grid reliability. Well-capitalized projects with mature power, water, interconnection and community strategies may benefit if the audit process separates executable projects from speculative queue positions.
